Eastridge Park Byrd Estates

Updates:

March 24, 2023: Paving work is currently in progress on the "Astronaut streets".

October 31, 2022: Bids were opened on August 25, 2022. Council award of the construction contract is scheduled for November 3.

Project Description:

RealTexasRoads LogoThis page is dedicated to street repairs in the Eastridge Park, Byrd Estates, Viva Drive, Catalina Drive and Flamingo Way areas. Repairs in these neighborhoods are funded through the Real. Texas. Roads. program and covers repairs on the following streets:

Street From To Repair Method Utilities
Belhaven Baker Motley Full Reconstruction Water Line Replacement
Cumberland Baker Motley Full Reconstruction Water Line Replacement
Eastbrook Baker Motley Full Reconstruction Water Line Replacement
Greenhill Baker Motley Full Reconstruction Water Line Replacement
Larchmont Baker Motley Full Reconstruction Water Line Replacement
Mark Baker Motley Full Reconstruction Water Line Replacement
Moreland Baker Motley Full Reconstruction Water Line Replacement
Whit Moreland Motley Full Reconstruction Water Line Replacement
Lovell John Glenn Fulton Full Depth Localized Concrete Repair None
Stafford John Glenn Gus Thomasson Full Depth Localized Concrete Repair Water Line Replacement
Schirra John Glenn Gus Thomasson Full Depth Localized Concrete Repair None
Anders John Glenn Gus Thomasson Full Depth Localized Concrete Repair None
Borman John Glenn Gus Thomasson Full Depth Localized Concrete Repair None
Fulton Town EastStafford Stafford Full Depth Localized Concrete Repair Water Line Replacement
John Glenn Town East Gus Thomasson Full Depth Localized Concrete Repair None
Viva Town East Parkside Full Reconstruction None
Catalina Town East Parkside Full Reconstruction None
Flamingo Way Concrete Drainage Channel Bamboo Full Depth Localized Concrete Repair None

Additional spot repairs throughout the Byrd Estates and Town East Estates areas will be determined by the Public Works Construction Inspector during construction.

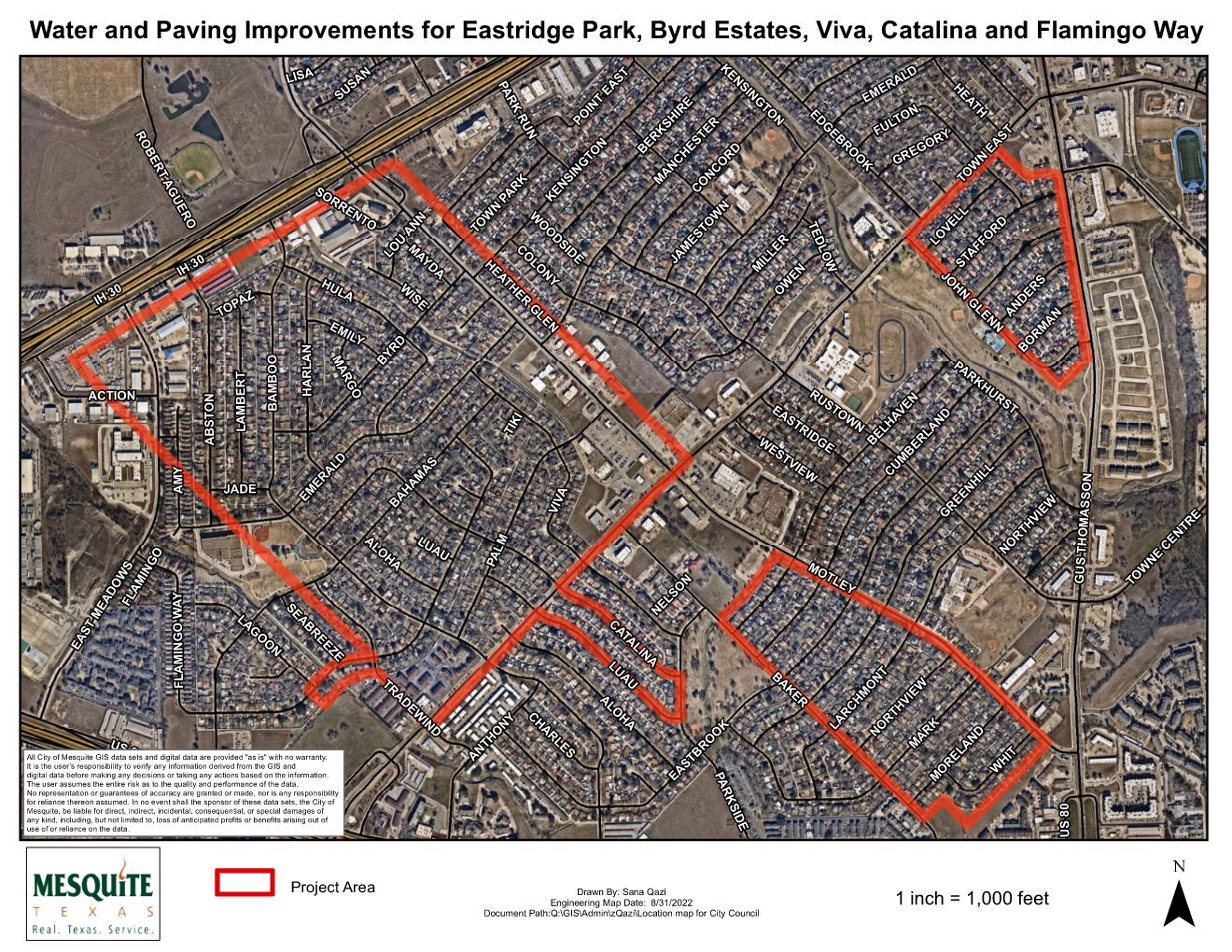

Location Map - Eastridge Park Byrd Estates

Expected Construction Process – Localized Full Depth Concrete Repair:

City staff will determine what areas of the street and sidewalk are in moderate to severe condition and the concrete at those locations will be removed and new reinforced concrete will be poured at those locations. This will not replace entire streets, but will rather replace only the moderate to severe locations of pavement failure. The concrete identified for replacement will vary in size and length. After the concrete is removed and replaced, the contractor will grade, place sod and clean up the area disturbed by the construction.

Expected Construction Process - Reconstruction

Reconstruction is a complete demolition and rebuild of a street. All curb and gutter and sidewalk is also typically replaced.


Real. Texas. Roads. is the program name for the road repairs funded by the $125 million bond sale approved by voters in November 2015. Repairs under this program are limited to residential, 2-lane roadways. Click here to see information on the entire program of road repairs.
